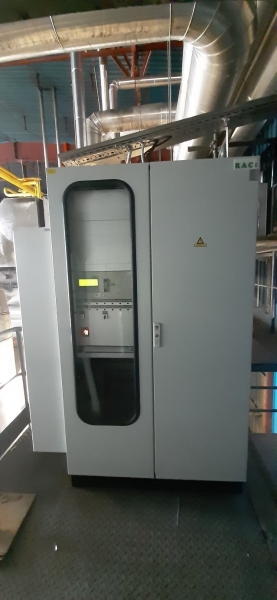

Project JP ENERGETIKA Ljubljana, TE-TOL Unit, Common Stack NTK
At JP ENERGETIKA LJUBLJANA we installed an automatic monitoring system (AMS) at the TE-TOL Unit in Ljubljana for continuous measurement of CO, NO, and O2 concentrations in the exhaust gases of the large combustion plant at the common NTK stack location.
Project KNAUF INSULATION, Common Stack
At KNAUF INSULATION in Škofja Loka, Slovenia, we installed an automatic monitoring system (AMS) for continuous measurement of concentrations of H2O, CO2, CO, N2O, NO, NO2, SO2, NH3, HCl, HF, CH4, C2H6, C2H4, C3H8, CH2O, C6H5OH and O2 in the exhaust gases from the stone wool production facility at the common stack location, with a compact CEMS II e system from GASMET Technologies.
Project KNAUF INSULATION, Melter Stack & Downstream Stack
We installed an automated measurement systems (AMS) for continuous measurement of H2O, CO2, CO, N2O, NO, NO2, SO2, NH3, HCl, HF, CH4, C2H6, C2H4, C3H8, C6H14, CH2O, CH5N, C2H7N, C3H9N, O2, TOC (TVOC), dust, flow rate, temperature and absolute pressure concentrations in the waste gases of a glass wool production facility at the Melter Stack and Downstream Stack at Knauf Insulation in Târnăveni, Romania, with COMPACT measurement system CEMS II e from the company GASMET Technologies, Thermo-FID FE analyser from the company SK Elektronik, QAL 182 WS from the company ENVEA and D-FL 220 from the company DURAG.

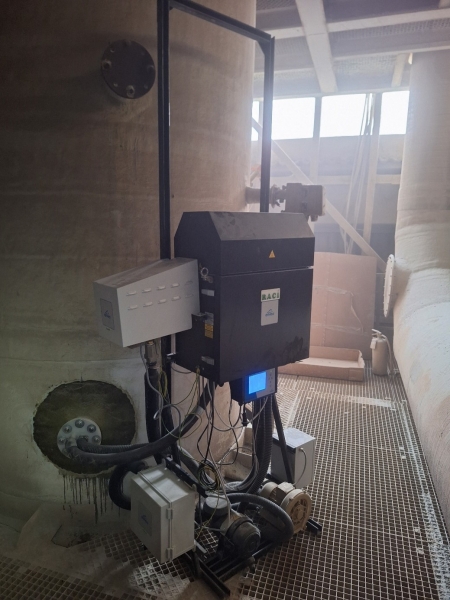

Project ELIXIR ŠABAC
At ELIXIR Šabac in Šabac, Serbia, we installed the QAL 182 WS extractive monitoring system from ENVEA (PCME) for continuous extractive measurement of dust concentration in the exhaust gases.
Project PODGORJE
At PODGORJE d.o.o. in Šentjernej, Slovenia, we installed an automatic monitoring system (AMS) for continuous qualitative measurement of dust concentration in the exhaust ducts of the dust collection systems.

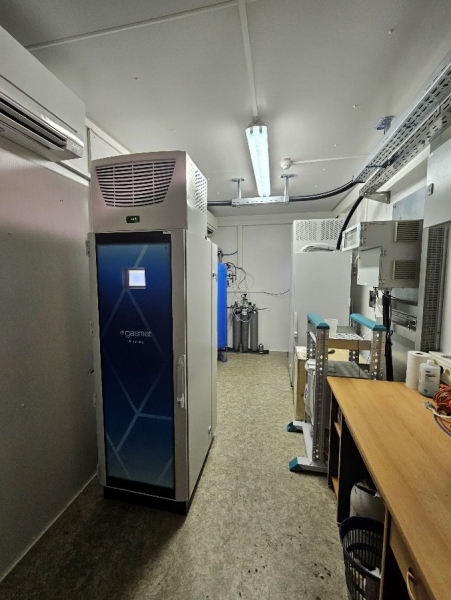

LEK Lendava, Incinerator
At LEK Lendava, Slovenia, as part of the CEMS system, we installed a system for continuous measurement of mercury (Hg) emissions, specifically the CMM system from GASMET Technologies.

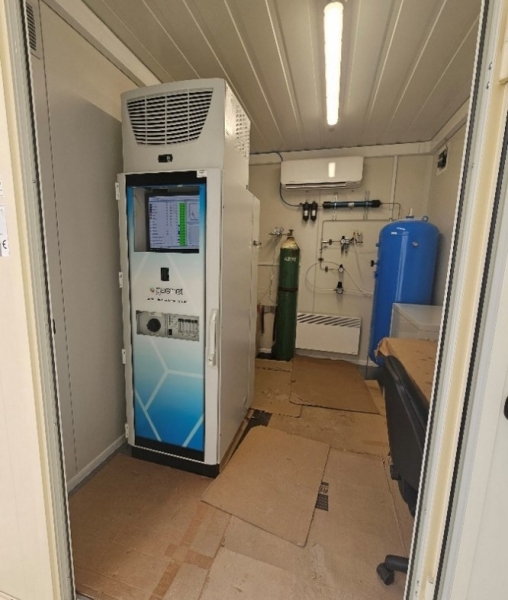

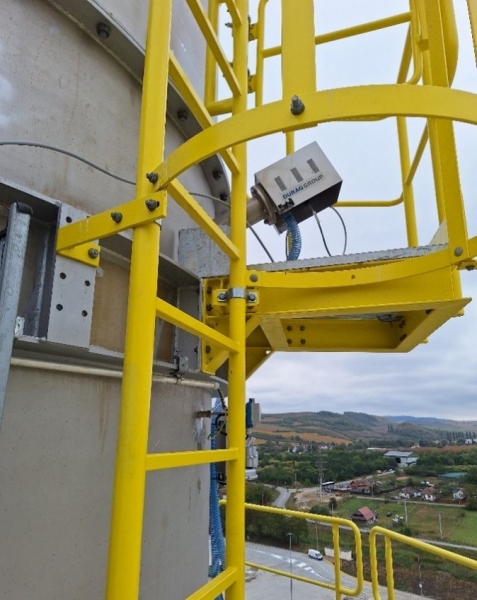

Project KNAUF INSULATION, Gas Melting Furnace
At KNAUF INSULATION in Škofja Loka, Slovenia, we installed an automatic monitoring system (AMS) for continuous measurement of oxygen concentration in the exhaust gases of the Gas Melting Furnace (Cupola 2). The AMS was supplied with a Siemens OXYMAT 61 E oxygen analyzer for measuring the O2 content.

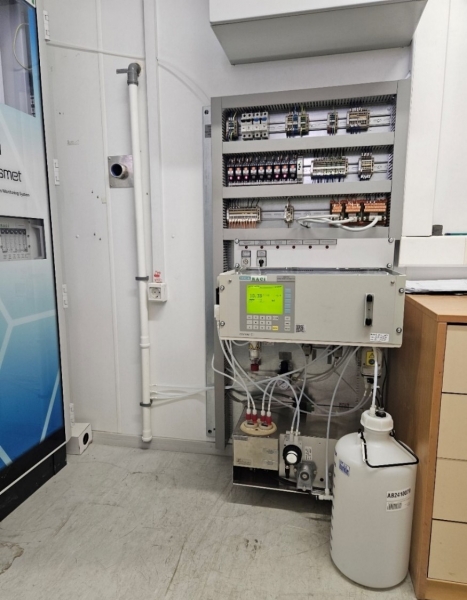

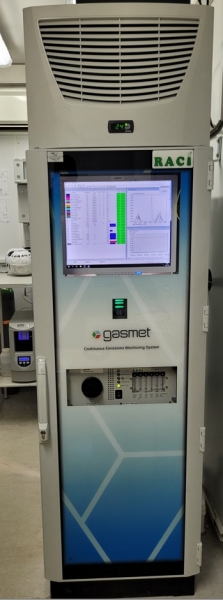

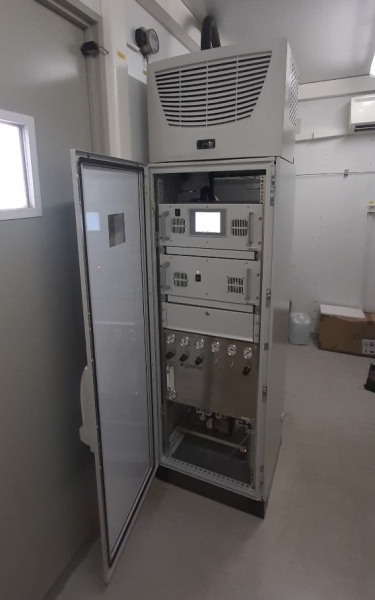

Project HOLCIM
We installed an automated measurement system (AMS) for continuous measurement of O2 content in the waste gases of cement production at the common Stack in the company Holcim Croatia in Koromačno, Croatia, with OXYMAT 61 analyser from the company SIEMENS.
Project MORAVACEM
We replaced an existing automated measurement systems (AMS) with an AMS for continuous measurement of H2O, CO2, CO, N2O, NO, NO2, SO2, NH3, HCl, HF, CH4, C2H6, C2H4, C3H8, C6H14, CH2O, O2 and TOC (TVOC) in the waste gases of cement production at the common Stack in the company Moravcem in Popovac, Serbia, with COMPACT measurement system CEMS II e from the company GASMET Technologies and Thermo-FID FE analyser from the company SK Elektronik.

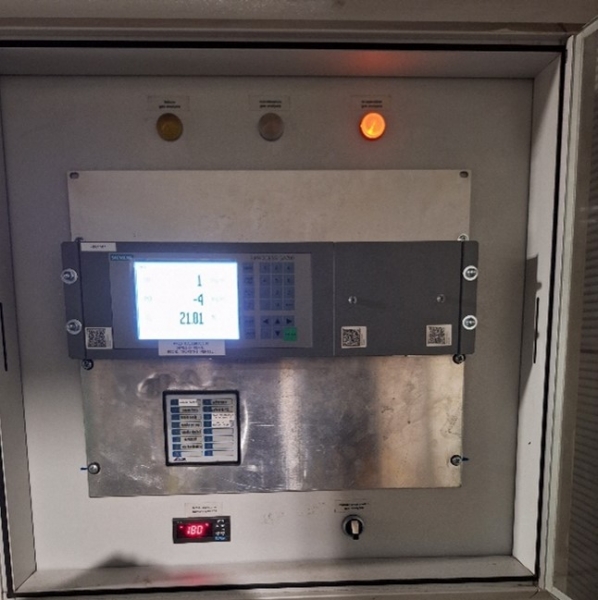

Project TEŠ
We carried out the renovation of CO, NO, and O2 automated measurement system (AMS) before the DENOx system at Block 6. We installed the SIPROCESS GA700 analyser with ULTRAMAT 7 module for CO and NO, and the OXYMAT 7 module for O2, from the company SIEMENS.
AMS for continuous measurement of NH3 and H2O concentrations in the waste gases in TEŠ
We installed an automated measurement system (AMS) for continuous measurement of NH3 and H2O concentrations in the waste gases of a large combustion plant at the horizontal duct of Block 5 at TERMOELEKTRARNA ŠOŠTANJ d.o.o., Šoštanj, Slovenia, with the LDS6 system from the company SIEMENS.
AMS for continuous measurement of H2O, CO2, CO, N2O, NO, NO2, SO2, NH3, HCl, HF, CH4, C2H6, C2H4, C3H8, C6H14, CH2O, and O2 concentrations in the waste gases in JP ENERGETIKA d.o.o.
We installed an automated measurement system (AMS) for continuous measurement of H2O, CO2, CO, N2O, NO, NO2, SO2, NH3, HCl, HF, CH4, C2H6, C2H4, C3H8, C6H14, CH2O, and O2 concentrations in the waste gases of a large combustion plant at the common stack at JP ENERGETIKA d.o.o. Ljubljana, TE-TOL Unit, Ljubljana, Slovenia, with COMPACT measurement system CEMS II e from the company GASMET Technologies.

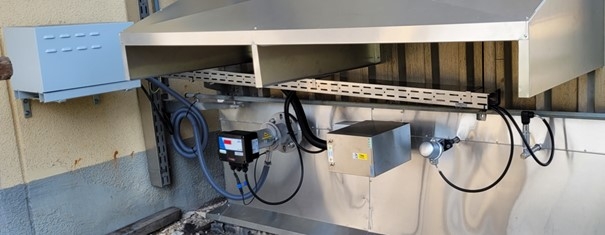

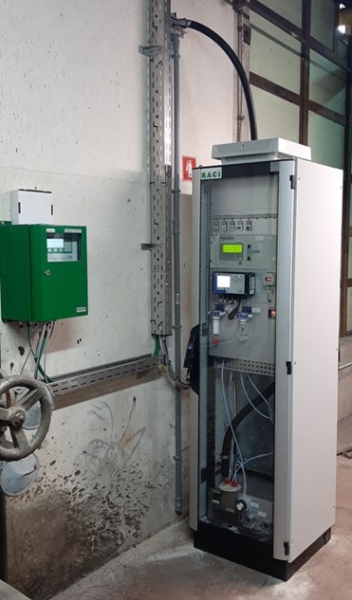

AMS for continuous measurement of CO, NO, SO2, O2, dust, O2 WET, temperature, and absolute pressure in PAPIRNICA VEVČE
We installed an automated measurement system (AMS) for continuous measurement of CO, NO, SO2, O2, dust, O2 WET, temperature, and absolute pressure in the waste gases of a medium-sized combustion plant, steam boiler (49.3 MWth) running on natural gas or oil, at PAPIRNICA VEVČE d.o.o., Ljubljana - Dobrunje, Slovenia.
AMS for continuous measurement of concentration in waste gases of cement production in HOLCIM
We have installed automated measurement system for continuous measurement of H2O, CO2, CO, N2O, NO, NO2, SO2, NH3, HCl, HF, CH4, C2H6, C2H4, C3H8, C6H14, CH2O, O2 and TOC (TVOC) concentrations in the waste gases of cement production at the location of a common chimney, in the company HOLCIM (HRVATSKA), Koromačno, Croatia with the COMPACT measurement system CEMS II e from the company GASMET Technologies and Thermo-FID FE analyser from the company SK Elektronik.

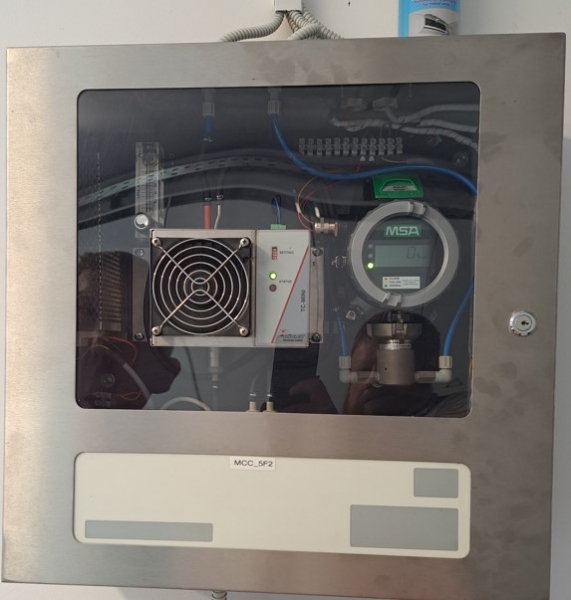

AMS to control the bio-stabilization hall in SIMBIO
We have installed automated measurement system for continuous measurement of LEL for ambient control of the bio-stabilization hall, in which an explosive mixture of air and methane can appear, in the company SIMBIO, d.o.o., Celje, Slovenia with the PrimaX P detector from the company MSA.

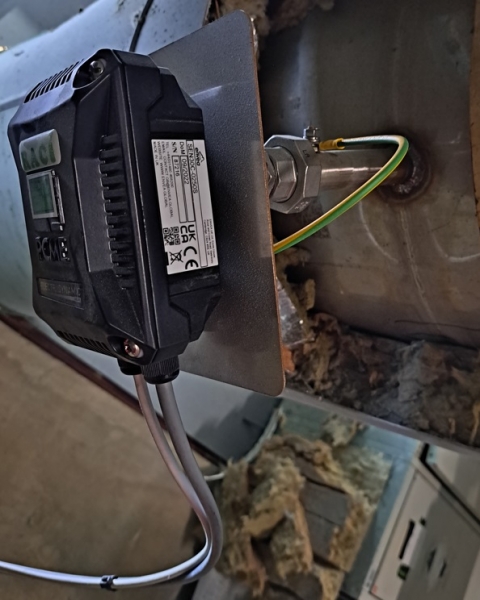

AMS continuous measurement of dust concentration Cinkarna CELJE
We have installed automated measurement system for continuous qualitative measurement of dust concentration in the ducts of the production line for Cuprablau, in the company CINKARNA Celje d.d., Celje, Slovenia with the PCME DustSense 30c measurement system from the company ENVEA.
AMS for continuous measurement of oxygen and combustible substances concentration in DS Smith, Belišće, Croatia
On the K3 steam boiler in the company DS Smith, Belišće, Croatia, we installed an automatic measurement system for continuous measurement of the O2 and COe (sum of unburned molecules - CO, H2, CxHy) ENOTEC COMTEC 6000.
GASMET Slovenia, Croatia, Serbia, Bosnia and Herzegovina, Montenegro, Kosovo and North Macedonia
We have extended our cooperation with GASMET to Serbia, Bosnia and Herzegovina, Montenegro, Kosovo and North Macedonia. Their best-selling products include:
- portable analyzers FTIR GT5000 Terra and FTIR DX4000,
- system for continuous emission measurements CEMS II e (with FTIR technology),
- system for continuous measurement of mercury CMM,
- system for long-term sampling of dioxins and furans GT90 Dioxin+.
P-AMS FTIR at the company KNAUF INSULATION and at the Faculty of Mechanical Engineering Ljubljana
We supplied mobile automatic measuring systems with DX-4000 FTIR analyzer from GASMET to the company Knauf Insulation d.o.o. Škofja Loka and the Faculty of Mechanical Engineering in Ljubljana.

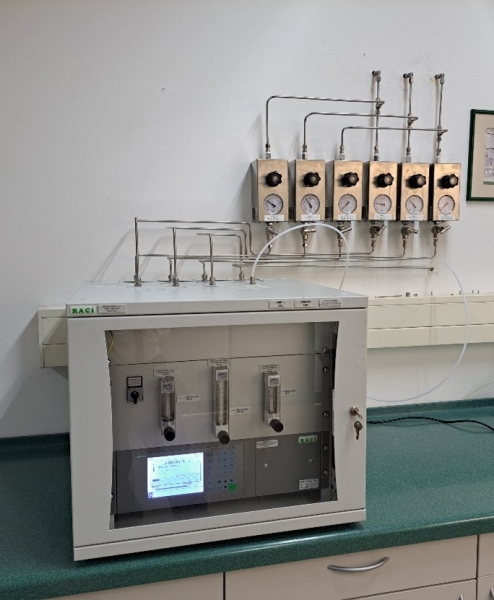

ISTRABENZ PLNI has two new automatic measuring systems for continuous CO2 concentration measurements
For the company ISTRABENZ PLINI d.o.o. for the needs of their laboratory in Koper and Celje, we supplied two automatic measuring systems for continuous measurements of carbon dioxide concentration in gas production:
- the 1st channel enables continuous measurement of the CO2 concentration (0-10/100 vol. %) and
- the 2nd channel enables continuous measurement of the CO2 concentration (95-100 vol. %).
A new system for continuous dust measurement in TE Plevlja
In the Thermal power plant Pljevlja we installed a system for continuous dust measurement, i.e. the PCME QAL 260 system from ENVEA.

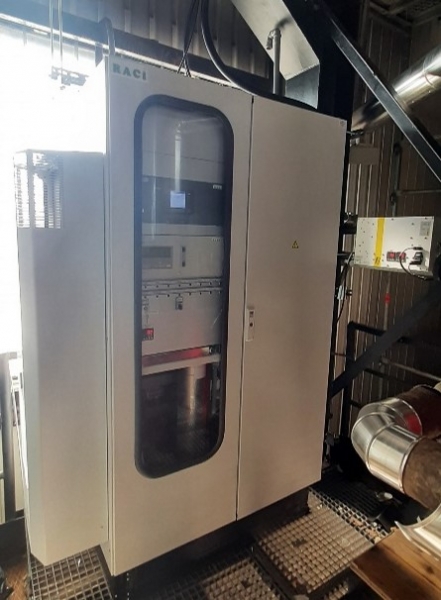

We delivered a system for extractive continuous dust measurement to TEŠ
To the company Thermal power plant Šoštanj d.o.o. we supplied the PCME QAL 182 WS extractive continuous dust measurement system from ENVEA.
New CEMS system in TOŠ
We supplied the CEMS system to Energetika Ljubljana d.o.o., a TOŠ unit; within the scope of which an automatic measuring system for continuous measurements of CO, NOX and O2 concentration on the new gas turbine was delivered and the DAHS EMIDATE system was upgraded with a new block.
Fire Laboratory ZAG
We supplied ZAG with measuring equipment for the needs of their Fire Laboratory. We supplied two mobile measurement systems, namely:
- P-AMS 1 for measuring the concentration of CO2, CO and O2 in waste gases, measuring the flow of the waste gases and measuring the optical density of the waste gases,
-P-AMS 2 for measuring toxic gases and vapors in waste gases using FTIR spectroscopy.

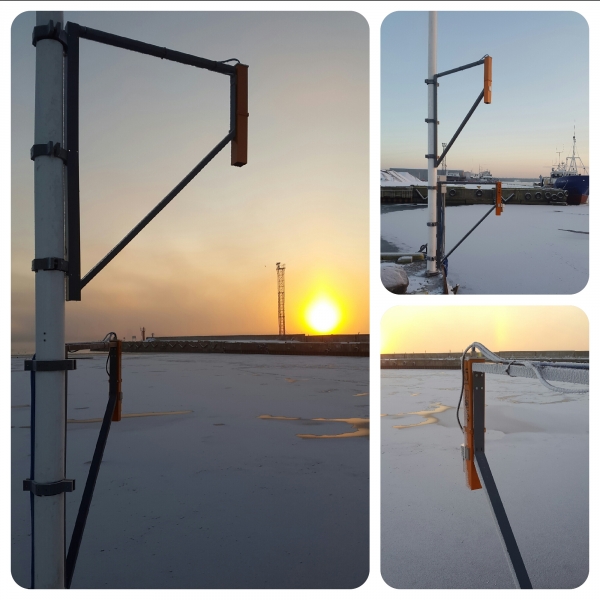

LDI ROW
We have added LDI ROW to our offer. The ROW (Remote Optical Watcher) is a non-contact sensor for detecting oil film on water's surface. It detects motor oils, turbine oils, vegetable oils, lubricant oils, hydraulic oils, mineral oils, fuel oils, crude oils, heating oils, gas oils, diesel, gasoline, kerosene, …
Highly accurate and easy to maintain, the ROW sensor detects and alerts you to unsuspecting oil spills. It provides 24/7 industrial and environmental water monitoring, whether at effluent discharge or influent intake points.
10th anniversary of the Excellent SME certificate
We are proud to be a part of the 10th anniversary of the Excellent SME Slovenia certificate, issued by the Chamber of Commerce and Industry of Slovenia. We received a plaque stating that we have been holders of the Excellent SME certificate for ten years and have achieved the highest credit ratings for 10 years in this entire period.

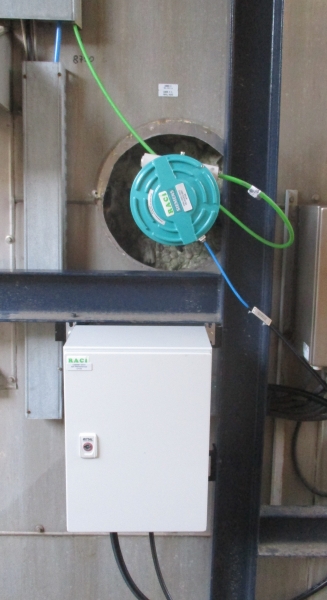

PLOMIN Thermal Power Plant has a new, automated measurement system for measurement of NH3 and H2O content
An automated measurement system with SIEMENS LDS6 for measurement of NH3 and H2O content in the waste gas of Large Combustion Plant Thermal Power Plant PLOMIN was installed.

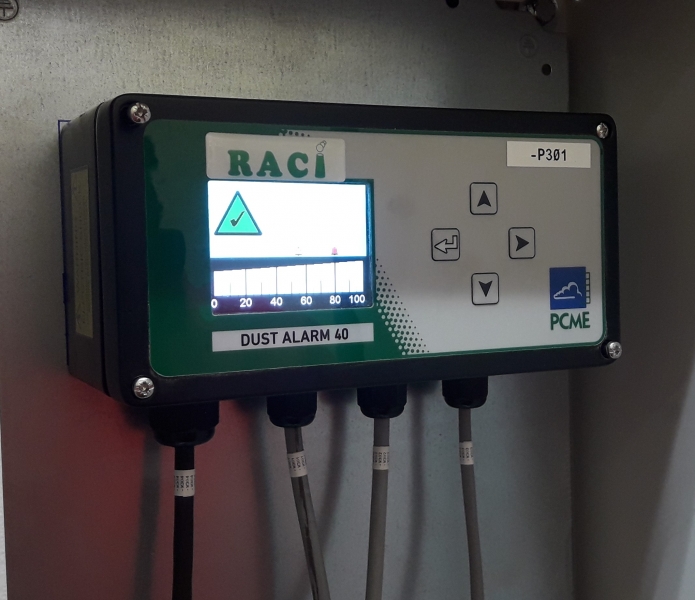

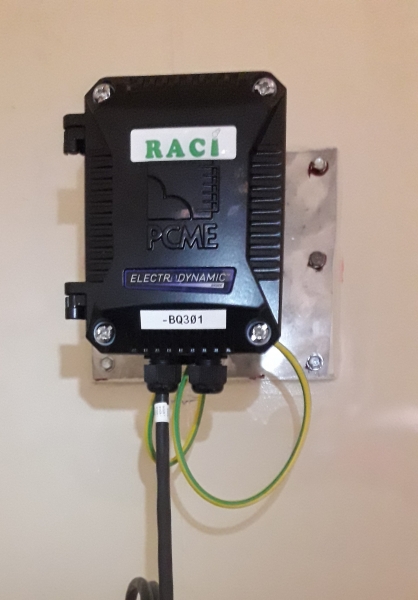

An automatic measurement system for qualitative dust measurement in KNAUF INSULATION Škofja Loka
We have installed several DUST ALARM 40's manufactured by ENVEA (PCME) for qualitative dust measurement on bag filters in KNAUF INSULATION ŠKOFJA LOKA.
An automated measurement system for measurement of TOC content in LEK Lendava
In LEK Lendava, we installed Thermo-FID FE produced by SK Elektronik for the measurement of TOC (TVOC) content in waste gases of the incineration plant.
Automatic extractive measuring system for continuous measurement of waste gas dust concentration
AMS for continuous measurement of carbon dioxide concentration with SIPROCESS GA700 analyzer in ISTRABENZ PLINI
We have installed an automatic measuring system for continuous measurement of carbon dioxide concentration in ISTRABENZ PLINI Celje and Koper with a SIEMENS SIPROCESS GA700 analyzer in gas production, thus enabling quality assurance and gas quality control (QA/QC).
Explosion-safe continuous measurement of waste gas flow rate in duct in SIJ ACRONI
We have installed an explosion-proofed automatic measuring system for continuous flow rate waste gas measurement XGM868i GE Sensing in SIJ ACRONI Jesenice.
GASMET Technologies FTIR AMS in LEK LENDAVA
At the end of 2021, LEK Lendava installed and successfully launched GASMET Technologies' FTIR AMS on the stack of the waste incineration plant.
FTIR GT5000 Terra
We have delivered a new type of portable analyzer FTIR GT5000 Terra, from the Finnish manufacturer GASMET Technologies, to the Department of Public Health PGC.
GASMET Technologies is a leading manufacturer of portable FTIR analyzers. A big advantage of these analyzers is the ability to measure up to 50 gases simultaneously. Versions of portable FTIR analyzers are useful for both emission measurements and for measurements of greenhouse gases, gases in the working environment, in fires and the like.
The GT5000 Terra is a useful and robust tool for measuring gases in the environment. The new versatile and even lighter analyzer in the portable product series represents a new generation of gas analyzers that combine high technology, ease of use and portability.
They also published an article in Novi List.
AMS for continuous measurement of O2 and COe in VIPAP
On the K6 steam boiler in the company VIPAP VIDEM KRŠKO, we have installed an automatic measuring system for continuous measurement of the O2 and COe (sum of unburned molecules - CO, H2, CxHy) ENOTEC COMTEC 6000.
AMS for continuous measurement of CO, NOX and O2 concentration on PB7 gas turbine in TEB
A system for continuous measurement of mercury emissions in HOLCIM Koromačno
We have installed our first CMM mercury emission measurement system from GASMET Technologies in a cement plant in Koromačno, Croatia, which operates fully automatically.
CEMTEC system installed in Lukavac Cement
We have installed together with the company ENOTEC the first CEMTEC system in the Balkans in 2020 in Lukavac Cement, BIH. It is a heated sampling probe for permanent sampling of a gas sample from a rotary kiln in a cement plant.
New AMS installed in the ZAG
We have developed an automatic measuring system (AMS) for testing of fire effluents. AMS allows simultaneous measurement O2 from three measuring points.
Field test of new Gasmet GT5000 Terra
With the brand new Gasmet GT5000 Terra we measured the gases inside containers. The results were in many cases alarming. We detected several toxic compounds with concentrations exceeding the TLV (Threshold Limit Value).
Many of the monitored gases are both invisible and odourless. According to the European Agency for Health and Safety at Work (EU-OSHA), each year in EU alone, 120 000 people develop cancer due to exposure of carcinogens at work, leading to an estimation of 80 000 deaths per year.
New FTIR AMS installed
In 2019 we have installed brand new FTIR AMS in ENERGETIKA LJUBLJANA, d.o.o. –TE-TOL with additional DUST and FLOW measurements in exhaust gases.
New AMS in KNAUF INSULATION, France.
We installed two AMSes in KNAUF INSULATION, ILLANGE, France for measuring of SO2, O2 , FLOW, DUST concentration and IN-SITU laser measurement of NH3 and H2O.
New O2 measurement in natural gas installed
For the company Plinovodi d.o.o. we have installed two AMSes for HC and H2O Dewpoint measurement in MMRP Ceršak and MMRP Rogatec. In 2019 we upgraded installed AMS in Ceršak with additional O2 measurement in natural gas.
Gasmet’s New Portable Gas Analyzer GT5000 Terra
25 YEARS OF RACI COMPANY
In 2019, company RACI d.o.o. is celebrating 25th anniversary. Today, we are pleased to be the leading local system integrator and supplier of continuous gas analysis systems. At the same time, our measurement laboratory and inspection body with our expertise ensures credible results of occasional and permanent emission and process measurements.
Obtained authorization of the Ministry of Environmental Protection and Energy of Croatia
We are happy to announce that we have obtained the authorization of the Ministry of Environmental Protection and Energy of Croatia to perform periodic measurements of the emission of substances into the air from stationary sources of pollution and inspection of automated measurement systems for emissions.
First FTIR AMS built-in with with domestic based knowledge
In 2018 we have built-in the first FTIR AMS in VIPAP VIDEM KRŠKO d.d. with domestic based knowledge. We are pleased that the system operates continuously and without errors.
